Project budgeting guide: summary and key takeaways
Budget before you scope: The budget conversation should start alongside the scope conversation, not after it. Waiting until the scope is locked turns budgeting into a rubber-stamp exercise.
Overhead kills margins quietly: Direct costs are easy to estimate; indirect costs like non-billable meetings, admin time, and context switching are where most budgets silently fail.
Contingency isn't padding: A 5 to 15 percent contingency reserve is a risk management tool, not a comfort blanket for bad estimates.
Tracking cadence matters more than tracking tools: Weekly budget reviews catch overruns before they become crises, regardless of which platform you use.
Profitability starts in the budget: If your budget doesn't connect to utilization rates and margin targets, you're managing costs without managing outcomes.
Every project I managed in my agency days started with the same optimistic spreadsheet. Three months later, that spreadsheet looked nothing like reality. The gap between the planned budget and the actual spend wasn't a math problem. It was a process problem.
This guide walks you through how to build, monitor, and protect a project budget from an operations perspective. You won't find a generic five-step checklist here. Instead, I'm sharing the framework I developed over years of running client service teams, refined by what I now see working across customers at Teamwork.com. Whether you're creating your first project budget or rebuilding a broken process, this guide gives you the structure and governance model to keep every dollar accountable.
What is a project budget and why does it matter?
A project budget is the financial plan that maps every anticipated cost to a defined scope of work, timeline, and set of deliverables. It covers direct costs (labor, materials, third-party services), indirect costs (overhead, admin, non-billable time), and contingency reserves for risks you can see coming but can't yet quantify.
If you want the full walkthrough on building one from scratch, our project budgets guide covers the foundational steps. In this guide, I'm going deeper: the operational layer that separates budgets that hold up from budgets that fall apart at the first change request.
Here's why this matters for operations directors specifically. You're the person who has to explain the gap when a project that was "on budget" still lost money. A budget that only tracks direct labor hours gives you a cost estimate, not a financial control system.
How to create a project budget step by step
In my experience before joining Teamwork.com, I found that teams usually know the steps to create a budget. The problem isn't the process; it's the rigor behind it. Here is the framework I recommend, with the operational checkpoints that most guides leave out.
Define scope and deliverables before you open a spreadsheet
Scope and budget are two sides of the same conversation. If you haven't locked the deliverables, resource requirements, and acceptance criteria, any budget number you produce is a guess. Our project budgets guide covers the scoping fundamentals in detail.
Map cost categories across direct, indirect, and overhead lines
This is where most budgets start to leak. Direct costs (billable labor, contractor fees, software licenses, materials) are the ones everyone remembers. Indirect costs are the ones that quietly erode your margin.
Here's a cost category framework I've used across dozens of projects:
Cost Category
The overhead allocation line is the one I see operations teams struggle with most. A pattern I kept seeing in my prior career, and still see at Teamwork.com, is teams that track every billable hour but treat non-billable time as invisible. If your team spends 20 percent of their week in internal meetings, client status calls, and administrative tasks, that cost belongs somewhere in your budget model.
For example, say you're budgeting a website redesign project with a team of four. Each person bills at $150 per hour. If you budget 400 billable hours ($60,000) but your team spends 480 total hours (80 in non-billable coordination), your true cost is $72,000. That $12,000 gap is the overhead your budget never accounted for.
Choose the right estimation method for the project type
Estimation is a discipline of its own, and we have a dedicated guide that covers project cost estimation methods in depth, including bottom-up, top-down, analogous, and three-point approaches. For this budgeting guide, the key takeaway is: match your method to your project's certainty level.
Build in contingency and risk reserves
Contingency isn't a line item you add to make the number feel safer. It's a calculated reserve based on identified risks. The Project Management Institute's PMBOK Guide recommends 5 to 15 percent of total project cost. The right number depends on three factors: project complexity, estimation confidence, and client relationship maturity.
Here's how I break it down:
Project Type
One critical distinction: contingency covers known unknowns (risks you can identify but can't yet size). Management reserve covers unknown unknowns and typically sits outside the project budget at the portfolio level. Mixing the two inflates your project-level budget and makes approval harder.
Identify and allocate resources
Resource allocation is where the budget meets reality. You need to know not just how many hours you need, but who is available, at what cost rate, and during which weeks.
The mistake I see most often is budgeting for an "average" team member. In reality, you need a senior strategist for the first two weeks and a junior designer for the last four. Blended rates hide this mismatch. Budget by role and seniority, then validate against actual availability before you commit the number to a client.
Get stakeholder approval and document assumptions
A budget without documented assumptions is a liability. Every budget I've seen fail in an escalation meeting failed because the assumptions were never written down. The project manager "knew" the scope included three rounds of revisions, but the client's signoff email said "reasonable revisions."
Document these at minimum: included and excluded deliverables, hourly rates and billing model (fixed fee vs. time and materials), revision and change request policy, contingency amount and release criteria, payment milestones and invoicing schedule.
Then get written sign-off. Not a Slack thumbs-up. A formal approval that references the document. This protects both the client relationship and your margin.
How to monitor and control your project budget
A budget that isn't actively monitored is just a wish list with numbers. In my years managing client service teams, I learned that the projects that stayed on budget weren't the ones with the best estimates. They were the ones with the tightest feedback loops.
For the tactical setup of cost tracking workflows, our project cost tracking guide covers the step-by-step process. Here, I'm focusing on the operational decisions that determine whether tracking actually prevents overruns.
Set a tracking cadence that matches project complexity
Not every project needs daily budget reviews, but every project needs a rhythm. For a two-week sprint, I recommend a midpoint check and a close-out review. For a three-month engagement, weekly reviews with a monthly stakeholder summary keep you ahead of problems.
Here's a cadence framework I've found effective:
Project Duration
The cadence should answer one question every time: "Are we on track to deliver within this budget, or do we need to adjust?" If your review doesn't produce a clear yes or a specific action item, it's a status meeting, not a budget review.
Use variance analysis to catch overruns early
Variance analysis compares planned spend to actual spend at a given point in the project. This is a core concept within earned value management, and the formula is straightforward:
A positive CV means you're under budget. A negative CV means you're spending more than planned for the work completed so far.
Here's a worked example. Your project budget is $50,000 for 500 hours of work. At the halfway mark (250 hours planned), you check the numbers: 260 hours have been logged, costing $27,300 against a planned $25,000.
Your CV is negative $2,300. That's a 9.2 percent overrun at 50 percent completion, projecting to roughly $4,600 over budget at delivery unless you correct course now.
The key is acting on the variance, not just reporting it. A 5 percent negative variance in week two is a conversation. A 15 percent negative variance in week six is a crisis.
Escalation triggers every ops director should define
Define your thresholds before the project starts. Here's the model I use:
Variance Level
Without predefined triggers, budget problems get escalated too late or not at all. The ops director ends up finding out about the overrun in a monthly P&L review instead of a weekly project sync.
Revenue, margin, and the budget-to-profitability connection
Most budgeting guides stop at "stay within the budget." But for operations directors, staying on budget is only half the picture. The real question is: did the project deliver the margin we planned?
This is the section most competitors skip entirely, and it's the one that matters most to anyone responsible for a P&L. A project can come in on budget and still destroy your margin if the budget was built on the wrong rate assumptions or if utilization dropped during delivery.
Here's the connection in simple terms:
If you bill a client $80,000 for a project and your total cost (including overhead allocation) is $64,000, your margin is 20 percent. That's healthy for most professional services firms. But if your team's utilization dropped to 65 percent during the project, the effective cost per billable hour went up. Bench time, context switching, and untracked non-billable work all contribute. Your real margin may be closer to 12 percent.
Metric
When one agency adopted a disciplined approach to tracking both billable and non-billable time, they saw the impact almost immediately. The Brand Leader, a creative agency using Teamwork.com, described the shift: "By understanding our cost centers and the cost per person per project, we're now more profitable and more efficient."
They tracked time down to the brainstorming session level and knew exactly when a project was about to cross the profitability threshold. Read The Brand Leader's full story.
If your budgeting process doesn't connect to utilization tracking and margin reporting, you're managing a spreadsheet, not a business. I use a utilization rate calculator to benchmark team performance against industry standards and identify where capacity leaks are hiding.
Common project budget mistakes and how to prevent them
I've watched enough projects go sideways to spot the patterns early. These are the three mistakes I see most often across customers we work with at Teamwork.com, and none of them are about math.
Underestimating overhead and non-billable time
This is the number one budget killer in professional services. Teams budget for billable hours and forget that every billable hour carries a shadow cost: the non-billable time required to coordinate, communicate, and manage the work.
A common rule of thumb is that for every eight billable hours, two to three hours of non-billable coordination occur. If your budget doesn't account for this, you're automatically 20 to 30 percent under-budgeted on labor before the project even starts.
The fix is simple but requires discipline. Track all time, not just billable time. Build a non-billable allocation percentage into every project budget based on historical data from similar projects.
Letting scope creep inflate the budget unchecked
Scope creep isn't a surprise. It's a pattern. Every experienced ops director knows that clients will ask for "just one more thing." The question is whether your budget has a mechanism to absorb it or flag it.
Here's what this looks like in practice. A client asks for "one more round of revisions" on a deliverable that was scoped for two rounds. Without a change request process, the team absorbs the extra work, and the project quietly burns through its contingency. With a process, the PM prices the additional round (say, 12 hours at $150 per hour, or $1,800), gets written approval, and the budget stays clean.
I recommend two approaches. First, include a defined change request process with a pricing model: hourly rate for out-of-scope work, approved in writing before execution. Second, build a scope buffer into the budget (typically 5 to 10 percent of direct labor hours) that gets released only when specific triggers are met.
Pro tip
The best defense against scope creep isn't a bigger contingency line. It's a clear change request process that the client agrees to before the project starts. Document it in the kickoff, reference it in every status update, and enforce it the first time it is tested.
Budgeting in isolation without cross-functional input
A budget built by one person reflects one perspective. The project manager might nail the labor estimate but miss the vendor costs. The account director might factor in client expectations but underestimate the technical complexity.
What I recommend, and what we see work across Teamwork.com customers, is a budget workshop model. Bring the PM, the technical lead, the account owner, and the ops director into a 30-minute working session during the scoping phase. Each person owns one piece of the estimate. The ops director owns the final assembly and margin validation.
Self-audit: Is your budgeting process on the right track?
Is your budgeting process set up to prevent these mistakes?
Do you track non-billable time on every project? (yes/no)
Do you have a written change request process that clients sign off on? (yes/no)
Does more than one person contribute to the budget estimate? (yes/no)
Do you review budget vs. actual spend at least weekly? (yes/no)
Is your budget connected to utilization and margin targets? (yes/no)
ACTION: If you answered no to two or more of these, your budgeting process has structural gaps that increase overrun risk on every project.
Using a WBS to build more accurate budgets
A work breakdown structure gives your budget a skeleton. Instead of estimating at the project level (which invites round-number guessing), you estimate at the deliverable or task level and roll the numbers up. I've found that teams who switch from top-down estimates to WBS-based budgeting reduce their estimation error by roughly half. Most see the improvement within two or three project cycles.
Here's how the WBS layers map to budget lines:
WBS Level
The deeper you go, the more accurate your estimate becomes, but the more effort it takes to maintain. For most professional services projects, Level 3 is the sweet spot. It gives you enough granularity to catch estimation errors without turning budgeting into a full-time job.
Here's a practical example. Say you're budgeting a brand strategy project. At the project level, a senior strategist might estimate "120 hours, $18,000."
At Level 3, you break it into: stakeholder interviews (20 hours), competitive audit (25 hours), positioning workshop (15 hours), brand guidelines document (40 hours), and revision cycles (20 hours). That totals 120 hours, but now you can see the brand guidelines document is the largest single cost driver. If the client pushes for a faster timeline, you know exactly where compression creates risk.
Key takeaway
Budget at the task level (WBS Level 3), not the project level. A project-level estimate hides errors. A task-level estimate exposes them before they compound.
How Teamwork.com helps you build and track project budgets
Everything I've covered in this guide, from scoping through monitoring through margin analysis, is easier when your projects, people, and finances live in one system. Here's how I've seen teams put these principles into practice using Teamwork.com. (For a comparison of project budgeting software options, our dedicated review covers the top platforms.)
Pro tip
Set up project templates in Teamwork.com with pre-built budget structures for your most common engagement types. It turns a 45-minute budgeting exercise into a 10-minute configuration and ensures every project starts with the same financial rigor.
Project budgets The budgets feature lets you set a total project budget (time-based, fee-based, or both) and track actual spend against it in real time. You can break budgets down by task list, which maps directly to the WBS approach discussed earlier. When spend crosses a threshold you define, the system flags it before it becomes a problem.
)
Time tracking Built-in time tracking captures both billable and non-billable hours at the task level. This feeds directly into your budget burn rate and eliminates the overhead gap that derails so many project budgets. Team members log time from the task view, the timer, or the timesheet, so the barrier to compliance is as low as possible.
)

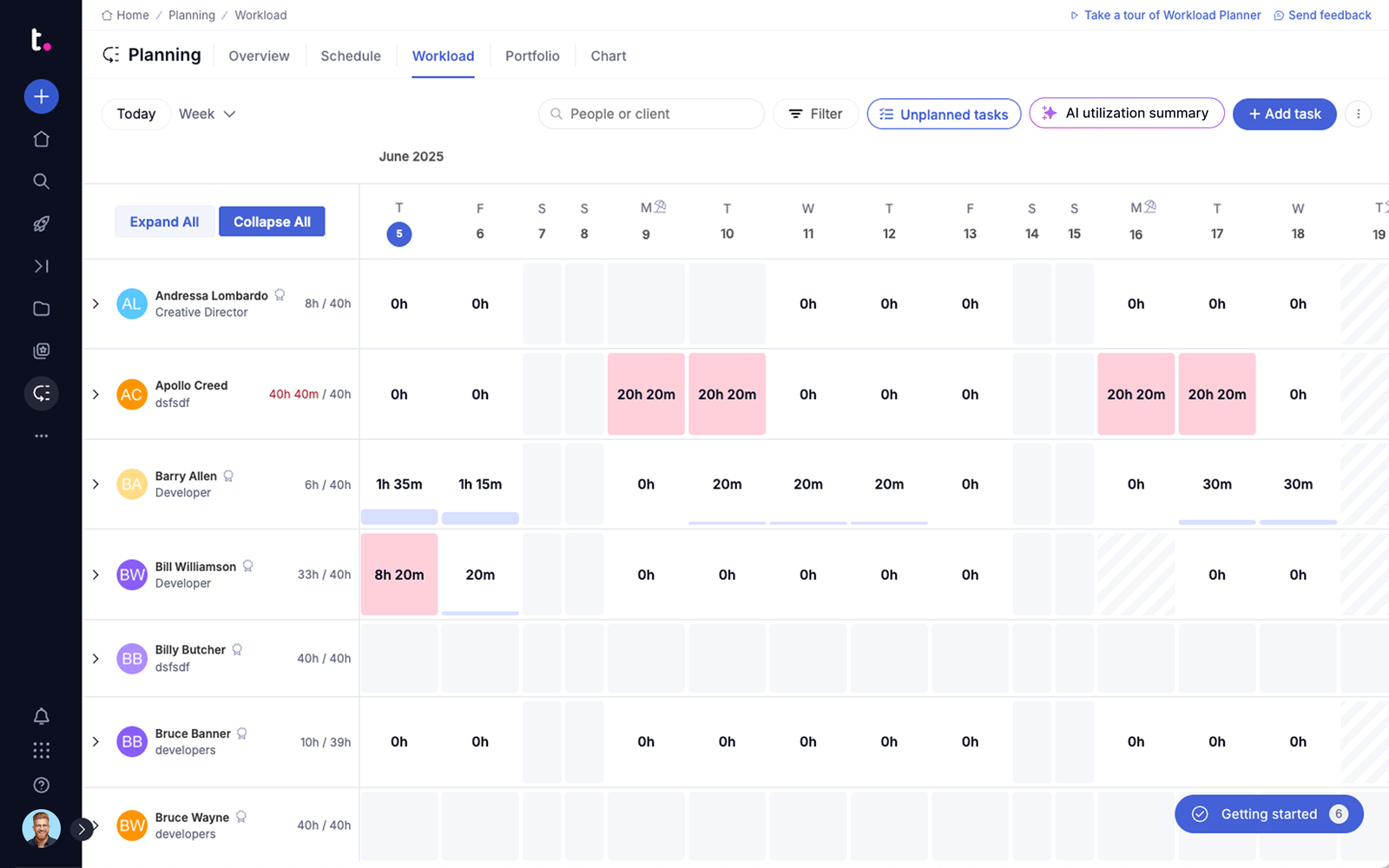

Resource scheduling and workload planner The resource scheduler shows who is available, who is overbooked, and where capacity gaps exist, all before you commit to a budget. Invanity, a UK-based digital marketing agency, cut time spent on weekly workload management by 80 percent after adopting the workload planner. On-time project delivery increased by 20 percent. Read Invanity's full story.
)
Profitability reporting The profitability dashboard connects budgets to revenue, showing margin at the project, client, and portfolio level. This is the view that closes the loop between "are we on budget?" and "are we actually making money?" It pulls in time data, cost rates, and billing rates to give you a single margin number.
)

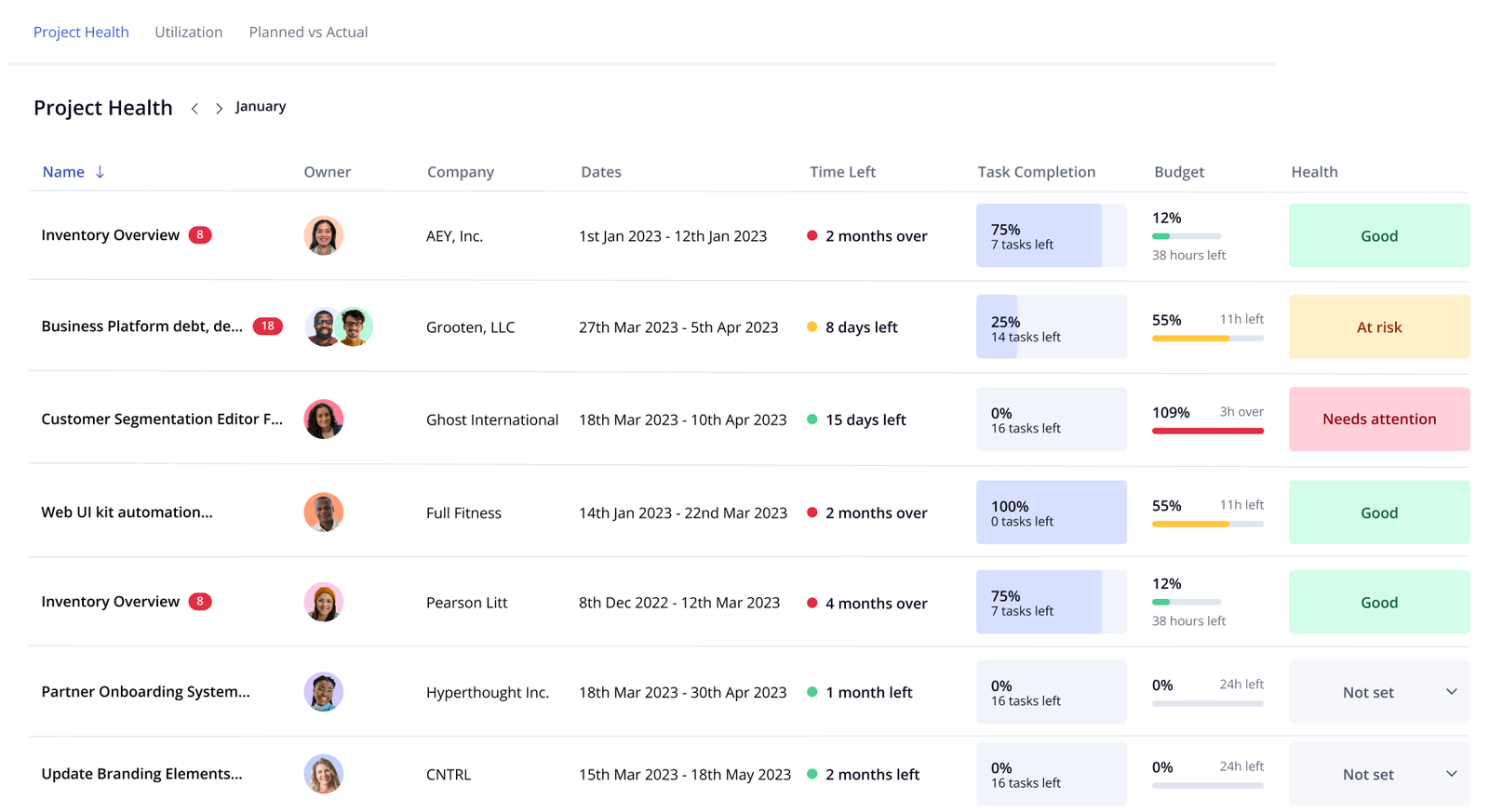

Project health dashboard Project health gives you a portfolio-level view of every active project's budget status, timeline, and risk indicators. For ops directors managing 10 or more concurrent projects, this is the early warning system that surfaces problems before they escalate. For a deeper look at project budget tracking as a discipline, our glossary breaks down the core terminology.
)
For teams that want to get started quickly, our templates library includes pre-built project structures that include budget frameworks you can customize for your workflow.
Project budgeting FAQ
What should a project budget include?
A project budget should include direct labor costs, direct non-labor costs (materials, software, vendor fees), indirect costs (overhead allocation, non-billable time), and a contingency reserve of 5 to 15 percent. It also needs to document the assumptions behind every line item, including billing rates, revision limits, and scope boundaries. The budget is incomplete without a change request process that defines how out-of-scope work gets priced and approved.
How often should you review a project budget?
Review frequency should match project complexity. For short engagements (under four weeks), a midpoint review and close-out review are sufficient. For longer projects, weekly budget reviews with a monthly stakeholder summary keep you ahead of overruns. The review should always answer one question: are we on track to deliver within budget, or do we need to adjust?
What do you do if your project budget gets cut mid-project?
Start by re-evaluating scope. A budget cut without a corresponding scope reduction is a margin crisis waiting to happen. Identify which deliverables are essential versus optional, and present the client with trade-off options: reduce scope, extend timeline, or accept lower quality on specific outputs. Document the revised agreement in writing before continuing work.
What's the difference between a project budget and a project estimate?
An estimate is a prediction of what something will cost based on available information. A budget is an approved financial plan with governance, tracking, and accountability built in. Estimates are inputs to budgets, not substitutes for them. For a deeper dive, our project estimates guide covers estimation techniques in detail.
How do you calculate contingency for a project budget?
Start with the base project cost (all direct and indirect costs before contingency). Apply a percentage based on project risk. Use 5 to 8 percent for repeat engagements, 10 to 12 percent for new clients or service lines, and 12 to 15 percent for innovation projects. Define specific release criteria for the contingency so it doesn't become a slush fund. For example: "contingency may be drawn against approved change requests or identified risk events only."
Who should be involved in creating a project budget?
At minimum, the project manager, the technical or creative lead, the account owner, and the operations director. Each person brings a different lens. The PM knows task-level effort, the technical lead knows complexity, the account owner knows client expectations, and the ops director validates margin and resource feasibility. A 30-minute budget workshop with all four perspectives produces a more resilient budget than any one person working alone.
)
)
)
)
)
)
)
)
)
)
